PD&E Study for Willoughby Boulevard Extension from State Road (SR) 714/Monterey Road to US 1/SR 5/Federal Highway​, Martin County, Florida

PD&E STUDY INCLUDES

Project Updates:

The project is currently progressing through the Project Development and Environment (PD&E) Study stage. The study is expected to be completed by August 2028. Below are current project updates.

The Public Kick-Off Meeting is scheduled for Wednesday, June 25, 2025, (Virtual), and Thursday, June 26, 2025, (In-Person):

  • Virtual: Persons who do not wish to attend the Public Kick-Off Meeting in person can join the meeting virtually at 6:00 p.m. on Wednesday, June 25, 2025. To register for the Public Kick-Off Meeting, please use the following link https://tinyurl.com/419669-3-Willoughby-Kickoff. To join by phone during the virtual meeting, please dial 1 (914) 614-3221, Access Code, 286-413-659. You will receive an email with a link to log in the day of the virtual meeting. If using a mobile device, the free “GoToWebinar” application is required to attend. Please allow adequate log-in time to view the presentation in its entirety.
  • In-Person: The Public Kick-Off Meeting will be held at the 10th Street Community Center, located at 724 SE 10th Street, Stuart, Florida 34994 on Thursday, June 26, 2025. The Public Kick-Off Meeting will begin at 5:30 p.m. as an open-house format. A formal presentation will begin at 6:00 p.m. followed by a comment period.

The same information will be presented at both the virtual and in-person Public Kick-Off Meeting, so attending both is not necessary.

Study Overview:

The Florida Department of Transportation (FDOT) is currently conducting a PD&E Study for the Willoughby Boulevard Extension from State Road (SR) 714/Monterey Road to US 1/SR 5/Federal Highway. A PD&E Study is FDOT’s process to evaluate the social, economic, and environmental impacts associated with a planned transportation improvement project. The purpose of this project is to provide system linkage in the roadway network by extending Willoughby Boulevard from its northern terminus and improve multimodal connectivity and mobility. A secondary purpose of the project is to address safety for bicyclists.

Purpose and Need:

The purpose of this project is to provide system linkage in the roadway network, reduce area congestion by providing an additional north-south corridor to improve movement of people and goods, improve travel, and safely accommodate bicycles and pedestrians to support the surrounding community's transportation needs.

Study Area:

   Scope of Work:

  • Provide more efficient system linkage​
  • Improve traffic operations​
  • Support transportation demand​
  • Improve safety for bicyclists

Project Schedule:

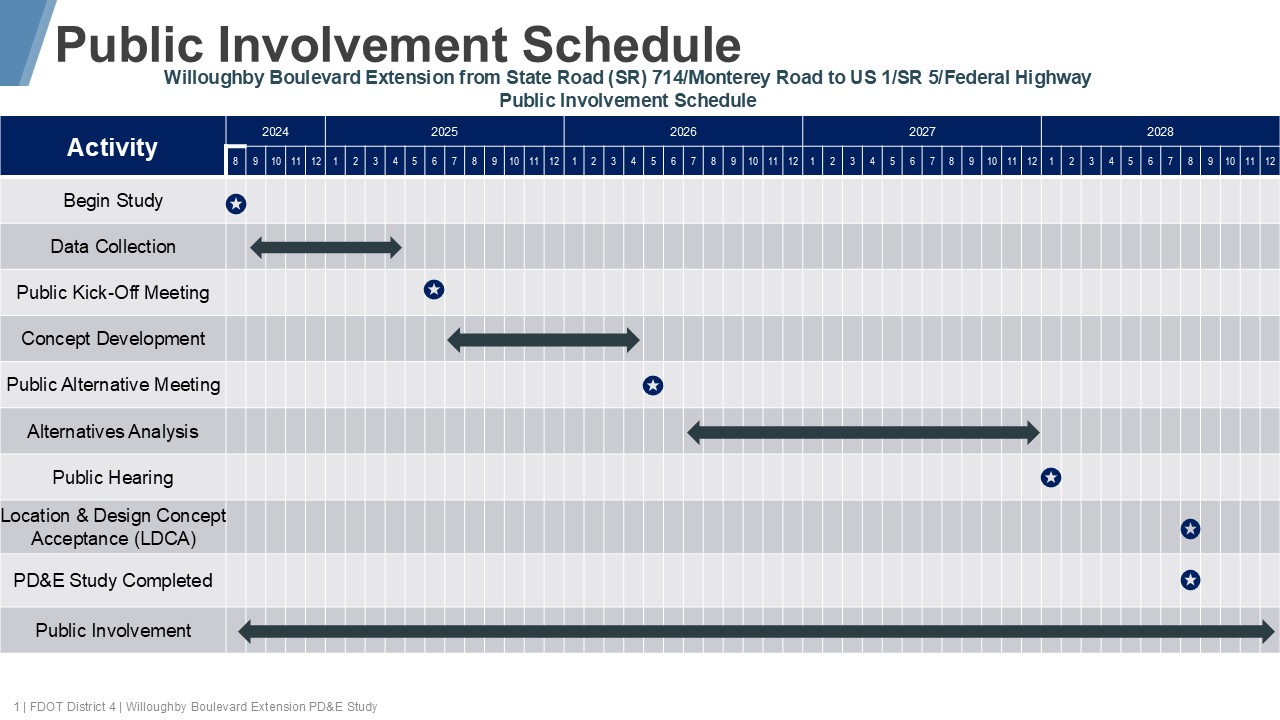

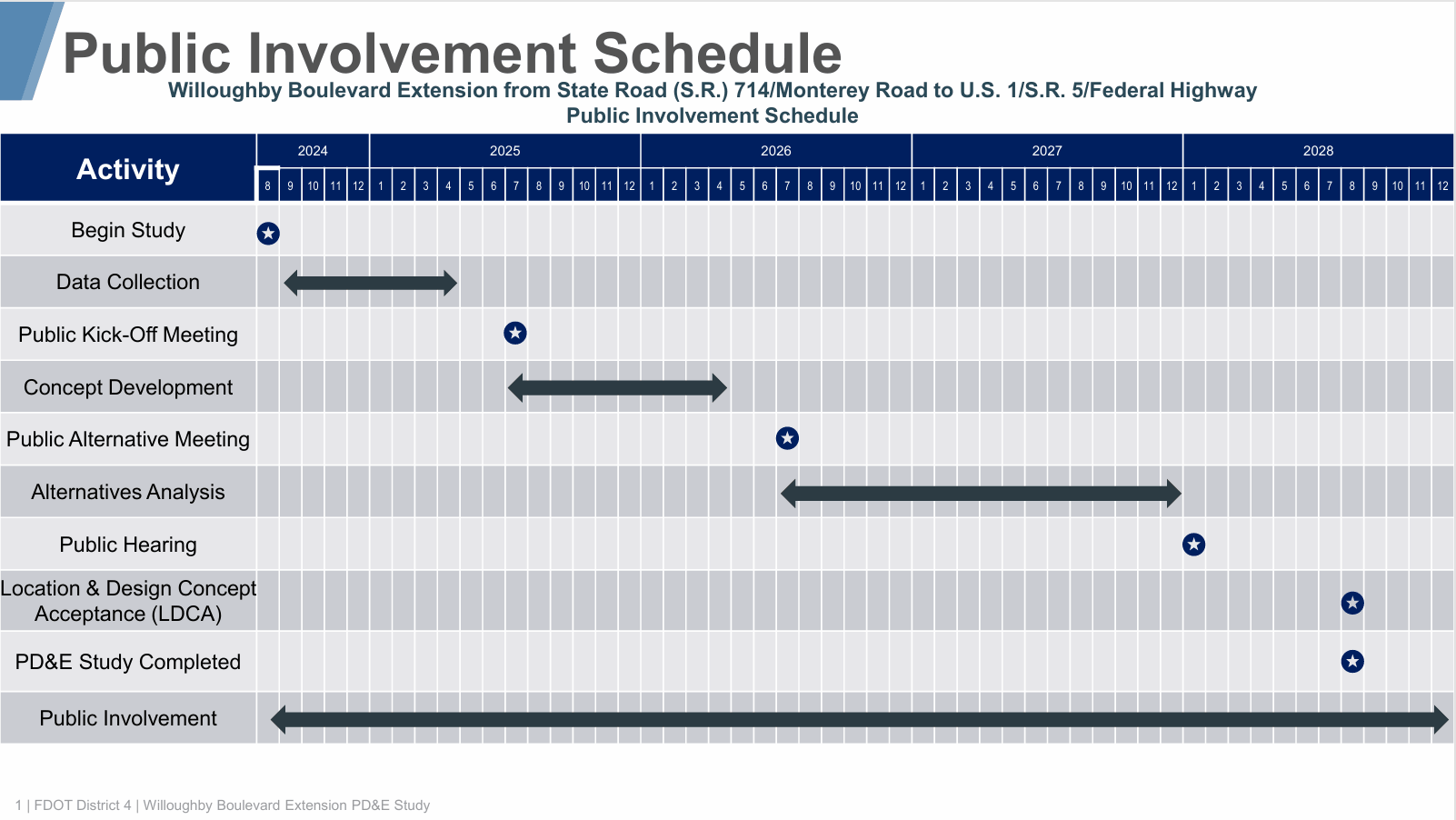

Willoughby Schedule

Funding:

  • PD&E – Funded
  • Design - Unfunded
  • Construction - Unfunded

District Office

Steven C. Braun, District 4 Secretary
3400 W Commercial Blvd.
Fort Lauderdale, FL 33309
Tel: 954-486-1400
Fax: 954-777-4197

Study At-A-Glance
Financial Project ID: 419669-3-22-03

Federal Aid Project No.: D423 042B

District Four (Southeast Florida)

PD&E Study Start Date
August 2024

PD&E Study Estimated Completion Date
August 2028

Cost

PD&E – Funded
Design - Unfunded
Construction - Unfunded

Lengths and Limits

Willoughby Boulevard Extension from State Road (SR) 714/Monterey Road to US 1/SR 5/Federal Highway

Project Manager
Maria Formoso, P.E., P.M.P
FDOT Project Manager
3400 West Commercial Boulevard
Fort Lauderdale, FL 33309

Phone: (954) 777-4677

Chris Rizzolo., P.E
Consultant Project Manager
AECOM
390 N. Orange Ave., Ste. 750
Orlando, FL. 32801
Phone: (407) 992-5794
